Shutdown scope

Shutdown Scope Management: Freeze Date and Emergent Work

Short answer

Shutdown scope management means agreeing the work list, freezing it when the plan and materials are built on it, and handling anything added later through a documented decision. Emergent and discovery work will occur, so plan contingency for it and record each change rather than absorbing it.

How MaintWiz helps: Scope grows after the freeze when added work is not visible. The MaintWiz shutdown module keeps scope, work packages and baselines in one plan along with change requests, so added work is visible. See the module · Get the scope freeze register

By · Published · Last reviewed

What MaintWiz adds:Scope and work packages in one planFindings go straight to the plannerBaselines show what movedReopen and close with a reason

Definitions

What is shutdown scope management, and what counts as scope creep?

Shutdown scope is the set of work agreed to be done in the stop, and scope creep is work added to it after scope freeze. The planned scope is fixed in advance, while emergent and discovery work arrives later and has to be handled through change control. 1

Planners around a conference table reviewing a shutdown scope hierarchy and risk matrix on a wall display
Illustration: A scope review: planners, operations and maintenance agree what is in, deferred or out before the scope freeze.

Emergent and discovery work will always occur. The aim is to plan for it with contingency, a decision rule and a record, so it is visible and not absorbed silently. The decision rule is in shutdown execution.

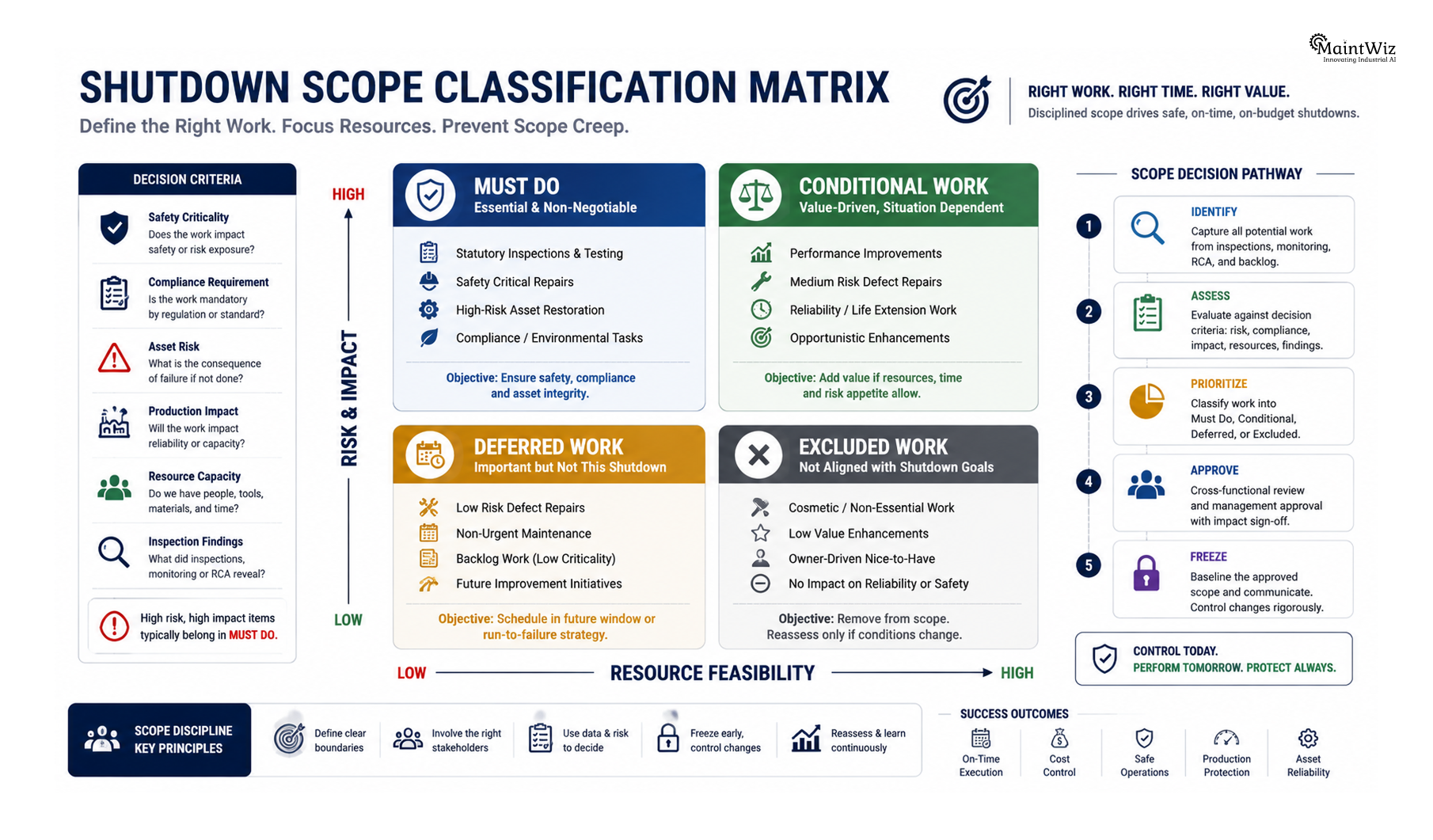

Planned scope

The tasks fixed in advance. NERC's generator reporting rules call this the original scope of work for a planned outage. 1

Emergent work

Work that appears after the scope is frozen but before the stop starts, for example a failure found in service.

Discovery work

Work found when equipment is opened. NERC treats discovery work and re-work as outside the original scope. 1

Scope creep

Additions that enter the plan after the scope freeze. Put each one through change control so it is a visible, approved decision.

Freeze

When should the shutdown scope be frozen?

Freeze the scope when the work list is complete and the plan, materials and budget are built on it, which for a large refinery turnaround means well inside the 1 to 2 years of planning that EIA describes. Set it from your longest lead item.2

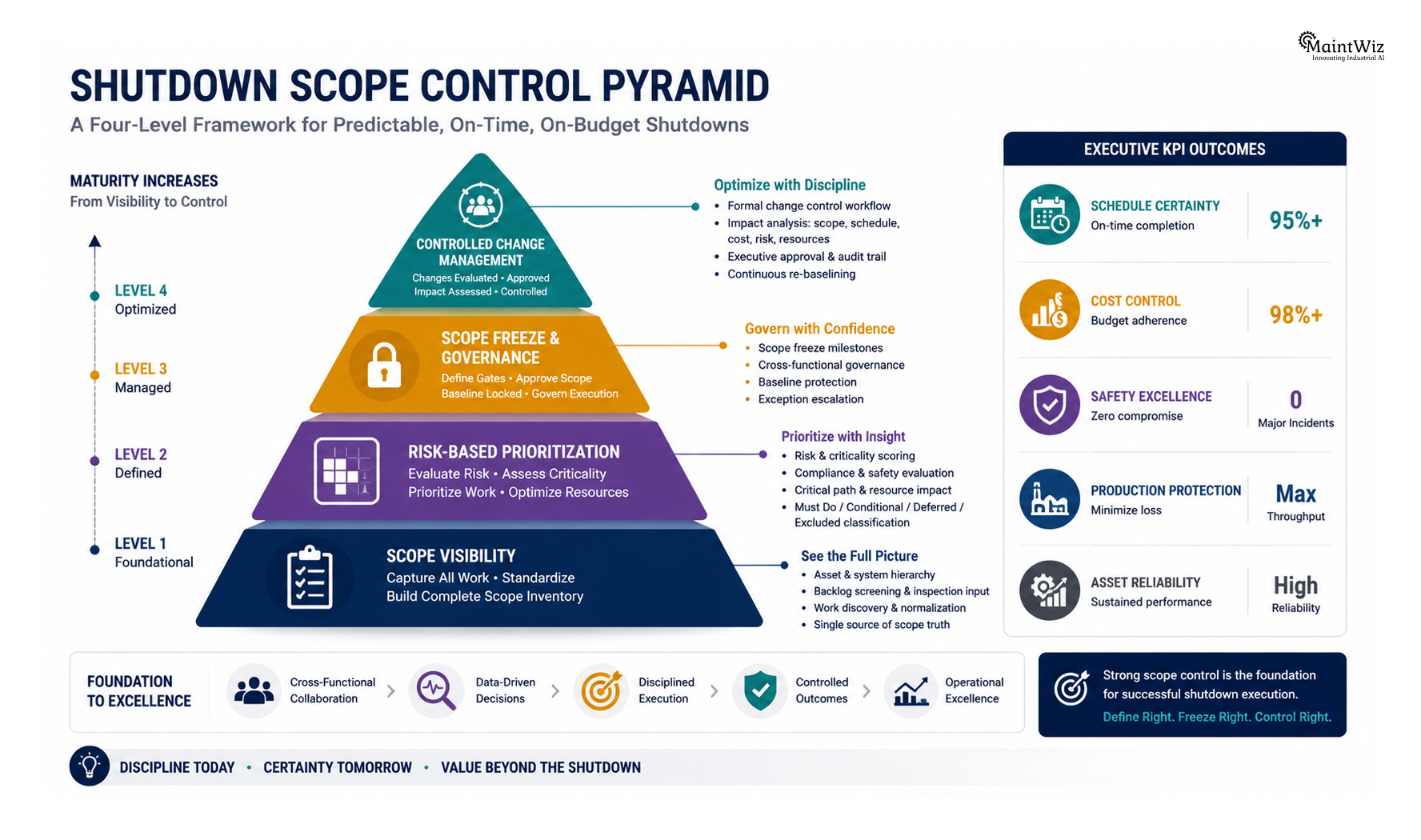

MaintWiz: scope funnel and where growth is, around the scope freeze
Scope funnel to the freeze. A card titled Scope funnel lists five stages, each with an item count and man-hours: Proposed, Screened, Approved, Frozen and Emergent. The Frozen bar is by far the longest, at 2,376 items and 421,457 man-hours, and Emergent reads 0.

Watch the Emergent line after the freeze: any item and man-hours that appear there are growth added after the scope was frozen. Each one needs an owner to approve or reject it against float and budget. The earlier stages show how much is still waiting for a decision.

Worked example setting a scope freeze date by subtracting the longest lead time from the shutdown start date
Set the freeze date from the longest lead time. A timeline from T-24 to T-0, shutdown start, with horizontal bars for permits (6 weeks), scaffold, contractor award, engineering and long-lead materials (20 weeks). A dashed line at T-20 marks the scope freeze.

Find the longest bar: long-lead materials start at T-20, so that sets the freeze, and every shorter item fits inside it. Replace the five lead times with your own and read off the date after which new work must go through change control.

Set the freeze date from the longest lead time: text version
Lead time itemWeeks before shutdown start
Permits6
Scaffold8
Contractor award10
Engineering14
Long-lead materials20 (longest: sets the freeze)

Scope freeze = shutdown start minus the longest lead time = T-20 weeks. Worked example with illustrative lead times.

Related: How to plan a plant shutdown · Shutdown spare parts planning · Turnaround cost estimate

For T&I scope and gates, see T&I turnaround and inspection planning. To see float after the freeze, paste the list into the Excel to Gantt tool. The scope freeze is a gate at about 90 days; see turnaround readiness review and phase gates.

DOE's contingency protocol notes that estimate uncertainty is expected to decrease as project definition improves, which is why a frozen, well-defined scope tightens the cost range. 4 GAO adds that baseline and current schedules should be subject to a change control process. 3

What must be true at the freeze

  • The work list is complete and each job has an owner
  • Every job has a priority and a reason: safety, integrity, regulatory or reliability
  • Job plans and work packages exist for the large jobs
  • Long-lead materials and contractors are identified and ordered
  • Budget, contingency and schedule are baselined against this list
  • The change request process is live and the decision group named

For an illustrative backward calendar with a freeze gate, see how to plan a plant shutdown.

Software

Where should the work list and change requests live?

The work list, its priorities and every change request should live where planning, materials and permits can see them, so a late job shows its full effect before it is approved.

Scope and baseline features are listed in the MaintWiz shutdown module data sheet. The shutdown module FAQ covers readiness gates and scope control. Digitizing the scope register first is covered in digital shutdown management.

What the shutdown module covers

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Sources of growth

Where does extra scope come from?

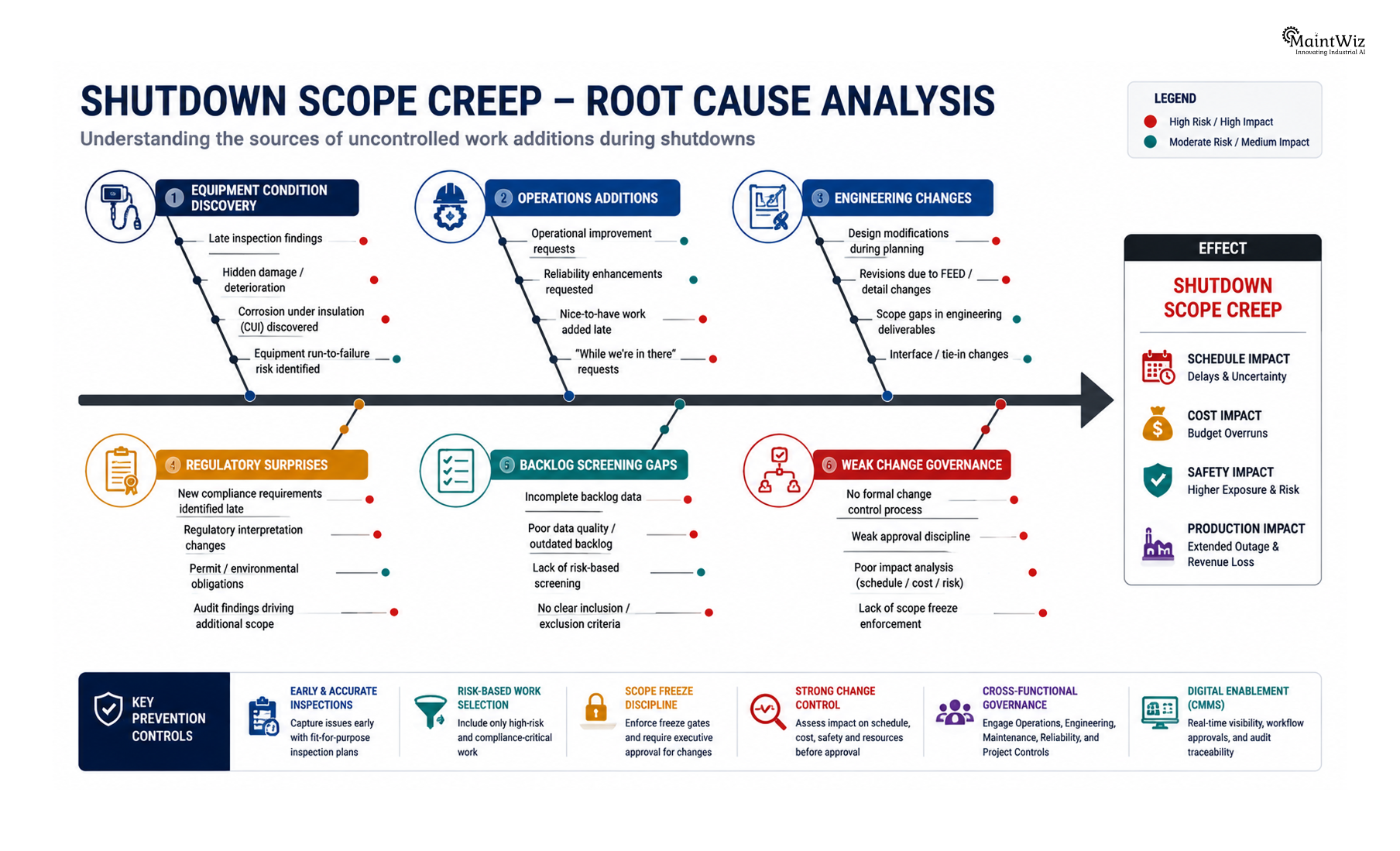

Extra scope comes from five places: emergent work, discovery work, late requests, modifications and inspection findings, and each needs its own control.

Scope growth is a leading cost driver: why shutdowns go over budget. With SAP PM, shutdown orders are grouped by a revision: SAP PM shutdown management.

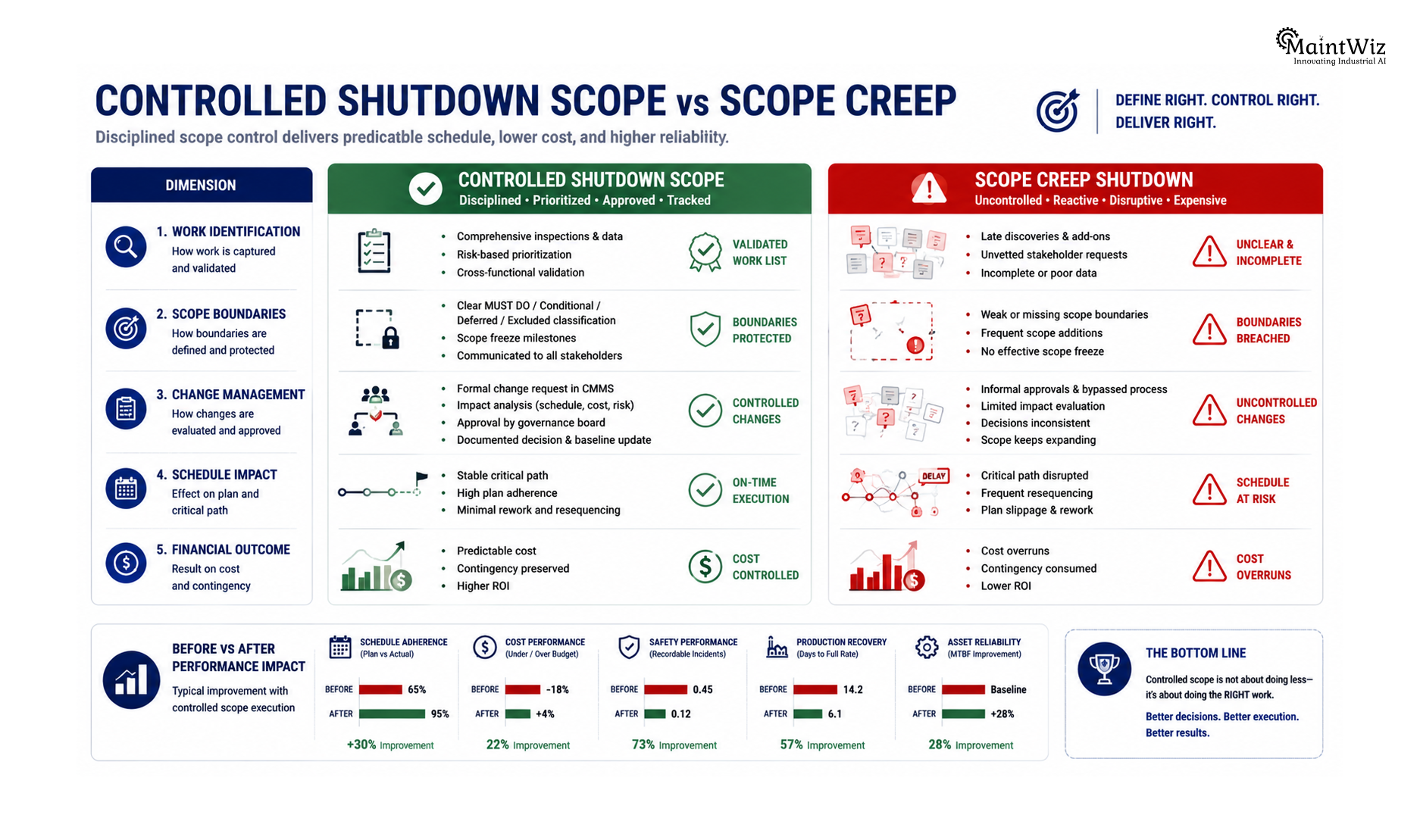

Where extra scope comes from and how to control it
SourceExampleControl
EmergentA pump found failing after the freezeChange request with a decision, drawn from contingency if approved
DiscoveryCorrosion found when a vessel is openedInspection findings logged on the day, with a pre-agreed rate and allowance for likely findings
Late requestsA new job someone wants done while the unit is downBacklog entry; accepted only through the freeze gate or change process
ModificationsA changed pipe route or control logicManagement of change review before the work is done 5
Inspection or regulatory findingsA statutory inspection finds a defectMandatory work approved outside normal prioritization, with the reason recorded

HSE guidance says to plan intrusive maintenance for shutdown periods, which is why the standing backlog fills up before the stop. 6

Calculator

How do you measure scope growth?

Scope growth is the work added after the freeze, less the work removed, divided by the frozen scope, expressed as a percentage. Agree one definition with your team before you measure.

The shutdown calculator tools page lists this and the other calculators. To see how added jobs move the critical path, use the Excel to Gantt tool. Scope growth in a worked example: shutdown case study.

Try it: scope growth by source

Enter the frozen scope in hours or cost and what was added or removed afterward. Nothing is sent or stored; the sums run in your browser. The numbers are for illustration.

Final scope
Net scope growth
Share from discovery
Share from late requests

The form

What should a scope change request record?

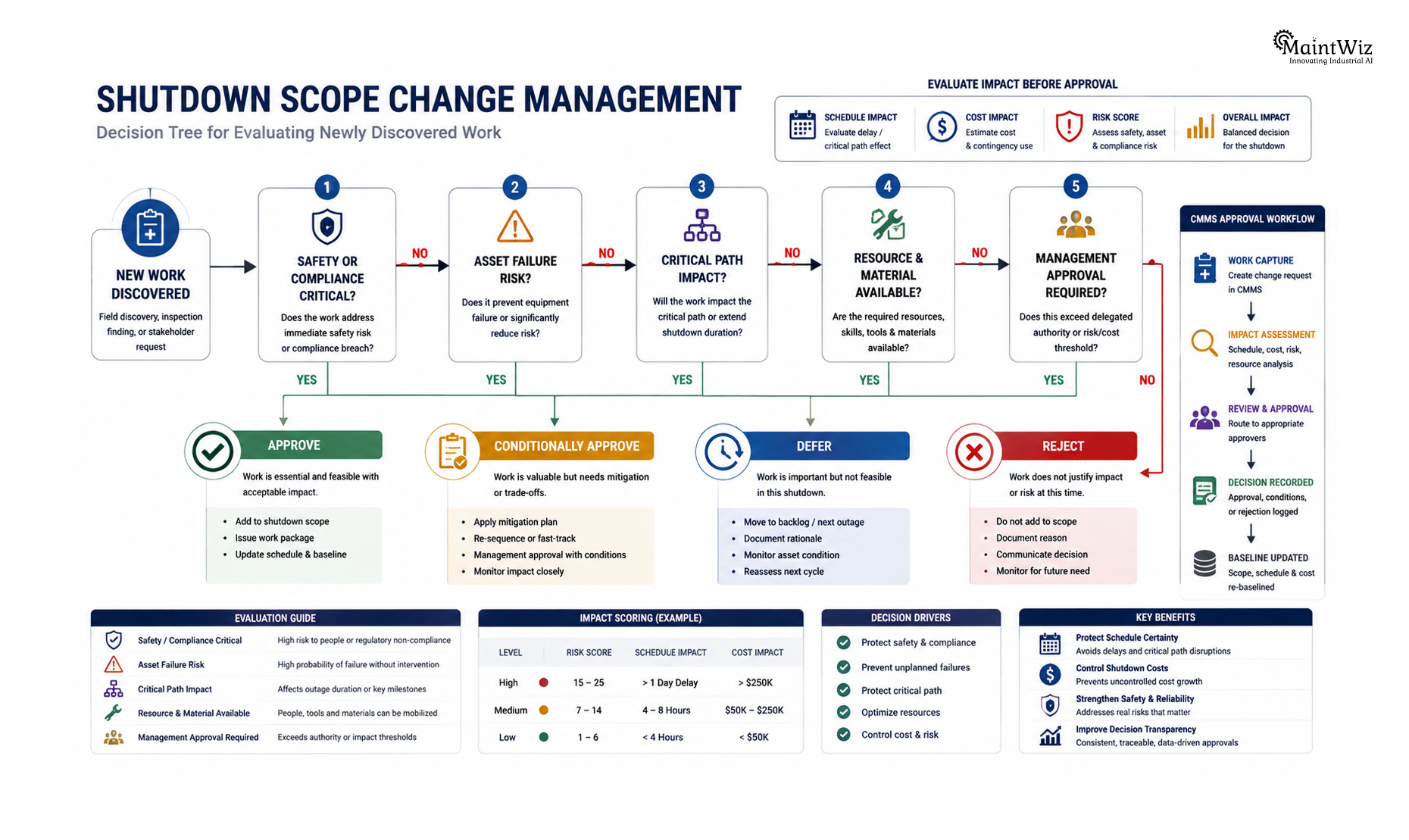

A scope change request records who asked, what, why, the cost and lead time, the effect on the critical path and the decision with its reason.

MaintWiz: scope hours added after the freeze and the change log
Scope change log after the freeze. Scope hours after the freeze (frozen scope, added, removed or deferred, current scope), a Changes by day chart of hours added and removed, and a Scope change log with number, day, kind, description, hours, raised by and status.

Read the log row by row: each change shows who raised it, the hours and whether it is approved or pending. The two pending rows carry an Approve button, so they are the decisions waiting. Compare the totals panel with the log to see how far current scope has moved from the frozen scope.

The scope freeze register template records each request and calculates scope growth by reason.

A scope change request
FieldWhat to record
Requester and dateWho asked and when
Work requestedWhat is to be done, on which equipment
ReasonSafety, integrity, regulatory, reliability or convenience
Cost and hoursEstimate, with materials and contractor effects
Lead timeWhether materials or specialists can arrive in time
Effect on the critical pathDays added or float used
DecisionApprove, defer or reject, by whom, with the reason

Backlog

What is a standing shutdown backlog?

A standing shutdown backlog is the running list of jobs that can only be done with equipment out of service, kept so that deferred and discovered work is ready for the next window. HSE guidance supports the logic: plan intrusive maintenance for shutdown periods to minimize isolation requirements. 6

A standing shutdown backlog
FieldWhy it matters
Job description and equipment tagMakes the job findable at the next scope challenge
Reason deferredSeparates "needs an outage" from "not yet planned"
EvidenceInspection result, failure history or photo
Needs an outage?Only unit-down jobs belong in the shutdown list
Lead time and materialsShows what must be ordered if the job is promoted

Unplanned stops are also windows for backlog work; see types of plant shutdowns.

Visuals

Save the scope charts

Two one-page charts for the planning room. Click either to open it at full size.

FAQ

Frequently asked questions

What is shutdown scope management?

Defining the work to be done in the stop, freezing it at a defined point, and controlling later additions through a documented decision process.

When should the shutdown scope be frozen?

Freeze when the work list is complete and the plan, materials and budget are built on it; for large refinery turnarounds EIA describes 1 to 2 years of advance planning. 2

What is the difference between emergent and discovery work?

Emergent work appears after the freeze but before the stop. Discovery work is found when equipment is opened, and NERC treats it as outside the original scope of work. 1

What is scope creep?

Work added to the plan after the scope freeze. Put each addition through change control so it is a visible, approved decision.

How do you calculate scope growth?

Add the work added after the freeze, subtract work removed, divide by the frozen scope and multiply by 100. The calculator above does it.

Why does a frozen scope matter for cost?

DOE's contingency protocol says estimate uncertainty is expected to decrease as project definition improves, so a defined scope narrows the range. 4

Does a late modification need more than a change request?

If it changes equipment, procedures or chemicals in a process covered by OSHA's process safety standard, management of change procedures apply, with replacements in kind excepted. 5

What is a standing shutdown backlog?

A running list of jobs that need equipment out of service, kept ready for the next window, with the reason deferred, evidence and lead time.

Control scope from the freeze to the last task

Book a demo and bring your scope list. We will show how work packages, baselines and findings work together.
